How Long Does a Kitchen Remodel Take?

Realistic kitchen remodel timelines for Tacoma homeowners. Phase-by-phase breakdown with Pierce County permit timelines and real project case studies.

Updated on May 06, 2026 • 10 min read

By Sergiu Bors • Owner

Share this post
Three-panel kitchen remodel progression from framing to cabinet install to finished kitchen, labeled Week 1, 2, and 3, with text "What is the Timeline?"

Short answer: anywhere from 2 weeks to 5+ months. The real answer depends on how much you're changing.

A cosmetic refresh (new paint, hardware, backsplash) can wrap in 2-4 weeks. A mid-range remodel with new cabinets, countertops, and flooring usually takes 6-10 weeks. A full gut renovation with layout changes and structural work? Plan for 12-20 weeks from demo to dinner in the new kitchen.

And that's just the construction window. Add in design, permitting, and material lead times, and the full timeline from first phone call to cooking in your new kitchen is longer than most people expect.

Here's what that looks like in Tacoma specifically, and how to avoid the delays that derail most projects.

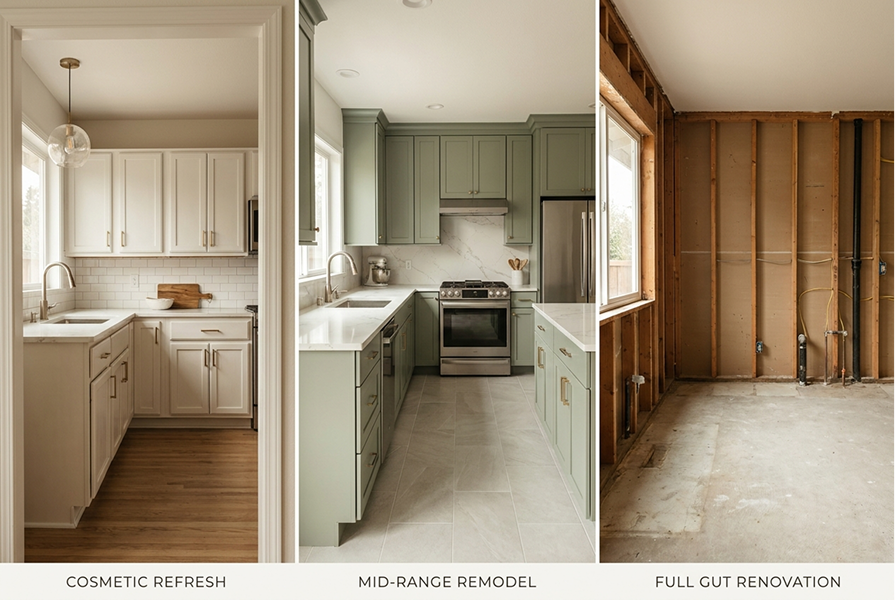

Three kitchen remodel scopes side by side — cosmetic refresh, mid-range remodel, and full gut renovation

Kitchen Remodel Timelines by Project Size

The biggest factor in your timeline is scope. Here's what each level looks like:

Cosmetic Refresh: 2-4 Weeks

You're keeping the same layout, same cabinets, same plumbing. The changes are surface-level:

  • Cabinet refacing or painting
  • New hardware (handles, pulls, knobs)
  • Backsplash upgrade
  • Fresh paint
  • New light fixtures
  • Swapping out a faucet

No permits needed. No structural changes. Most of this work can happen while you're still using the kitchen (with some inconvenience).

Mid-Range Remodel: 6-10 Weeks

This is where you're replacing major components but keeping the existing layout:

  • New cabinets
  • New countertops (granite, quartz, butcher block)
  • New flooring
  • New appliances
  • Updated lighting
  • Possible plumbing fixture upgrades (sink, faucet, disposal)

You'll likely need permits for electrical and plumbing work in Pierce County. Material lead times add to the front end, especially for custom or semi-custom cabinets (6-10 weeks from order to delivery).

Full Gut Renovation: 12-20+ Weeks

Everything comes out. The kitchen is stripped to the studs and rebuilt:

  • Complete layout changes (moving walls, islands, plumbing runs)
  • Structural modifications (removing load-bearing walls, adding headers)
  • All new mechanical (plumbing, electrical, HVAC)
  • New cabinets, countertops, flooring, appliances, fixtures
  • Possible window or door relocations

This scope requires multiple permits, multiple inspections, and a longer design phase. The total timeline from initial consultation to finished kitchen often stretches to 4-5 months when you include pre-construction planning.

Quick Comparison

Project Scope Construction Time Total Time (Including Planning)
Cosmetic Refresh 2 - 4 weeks 3 - 6 weeks
Mid-Range Remodel 6 - 10 weeks 10 - 16 weeks
Full Gut Renovation 12 - 16 weeks 16 - 24 weeks

The Phases of a Kitchen Remodel (Week by Week)

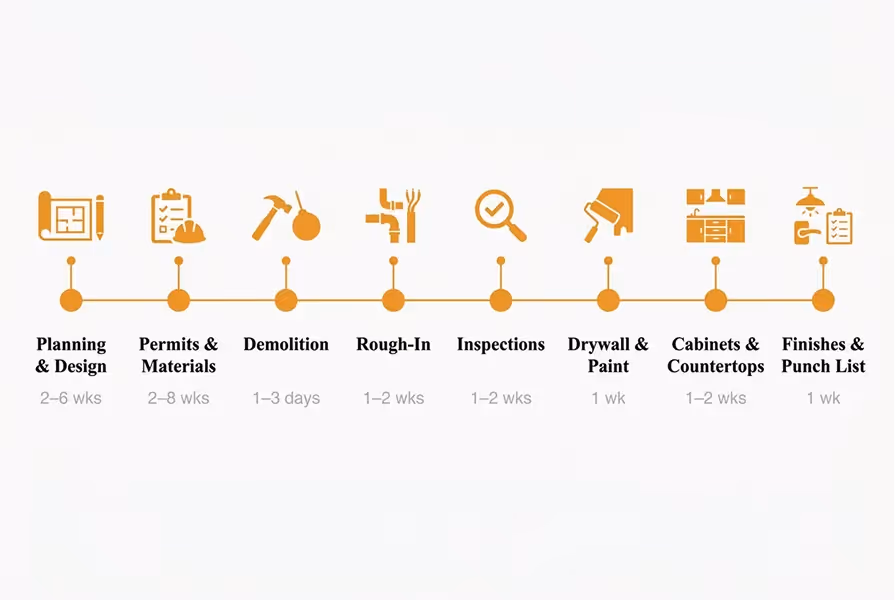

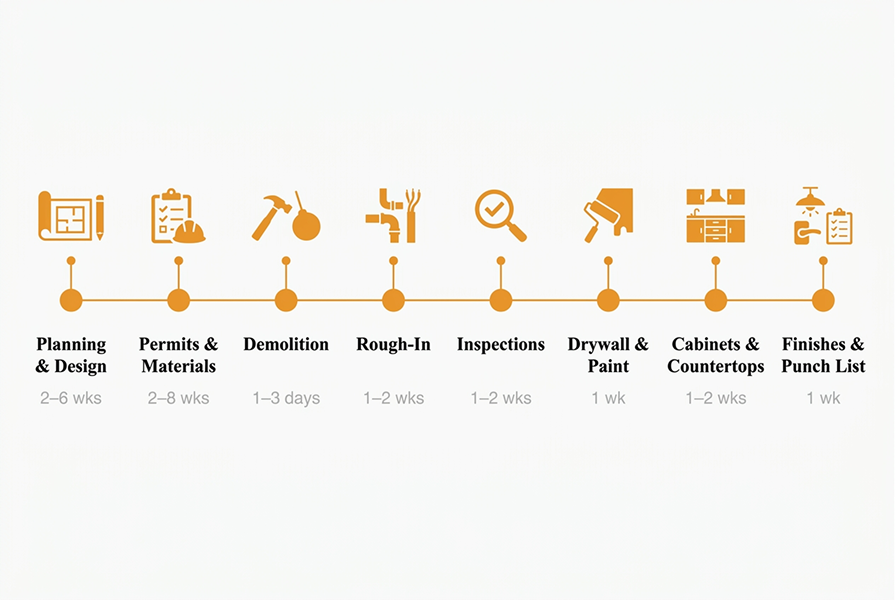

Kitchen remodel phase timeline from planning through final inspection

Every kitchen remodel follows the same basic sequence, whether it takes three weeks or five months. Here's the phase-by-phase breakdown:

Planning and Design: 2-6 Weeks

This is the phase most homeowners underestimate. Before anyone swings a hammer, you need to:

  • Define your scope and budget
  • Choose a contractor (get at least 2-3 quotes)
  • Finalize your layout and design selections
  • Pick cabinets, countertops, flooring, appliances, fixtures, lighting
  • Create a materials list with specifications

The timeline here is almost entirely in your hands. Homeowners who make decisions quickly move through this phase in 2 weeks. Those who go back and forth on countertop colors or cabinet styles can stretch it to 6+ weeks.

Permits and Material Ordering: 2-8 Weeks

Once the design is locked, two things happen in parallel:

Permits: If your project involves electrical, plumbing, or structural changes, you'll need permits from Pierce County. Current processing times run 2-4 weeks for residential permits, though simple mechanical permits can sometimes move faster. Your contractor should handle the permit application. More on Pierce County specifics below.

Materials: This is where custom cabinets can blow up your timeline. Stock cabinets ship in 1-2 weeks. Semi-custom: 3-6 weeks. Fully custom: 6-10 weeks. Countertops need 2-4 weeks after templating (which can't happen until cabinets are installed). Appliances are generally in stock, but specialty items can have lead times.

Pro tip: Order materials as early as possible. Waiting until permits are approved to start ordering adds weeks to your project.

Demolition: 1-3 Days

The fun part (if you're not the one doing it). Demo for a mid-range kitchen remodel takes 1-2 days. A full gut with wall removal takes 2-3 days. This includes removing old cabinets, countertops, flooring, appliances, fixtures, and any walls or framing that need to go.

Rough-In: Plumbing, Electrical, HVAC (1-2 Weeks)

If you're moving plumbing lines, adding circuits, or rerouting HVAC, this work happens with the walls open. Rough-in plumbing and electrical need to be inspected before you can close up the walls.

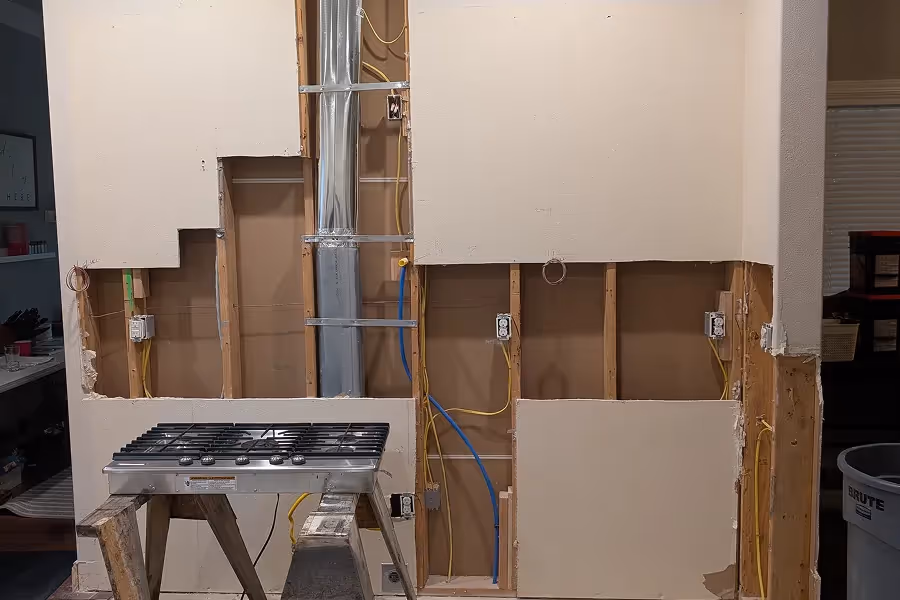

Open kitchen walls during rough-in phase showing plumbing and electrical work in progress

Inspections (1-2 Week Wait in Pierce County)

Pierce County requires inspections at key milestones: rough-in plumbing, rough-in electrical, framing (if structural work was done), and a final inspection. Scheduling an inspection typically takes 3-7 business days once you request it. Plan for 1-2 weeks of downtime at this stage while you wait for inspectors.

Drywall and Paint: 1 Week

Once inspections pass, walls get closed up, patched, textured, and painted. If you're doing a full paint job on the entire kitchen, add a couple of extra days.

Cabinets and Countertops: 1-2 Weeks

Cabinets go in first. Depending on the size of your kitchen and the complexity of the layout, installation takes 2-5 days. After cabinets are set, a countertop fabricator comes to template. Then you wait 2-4 weeks for fabrication and installation.

This is the most common bottleneck in kitchen remodels. Countertops can't be templated until cabinets are installed, and they can't be installed until they're fabricated. That 2-4 week gap is built into every project.

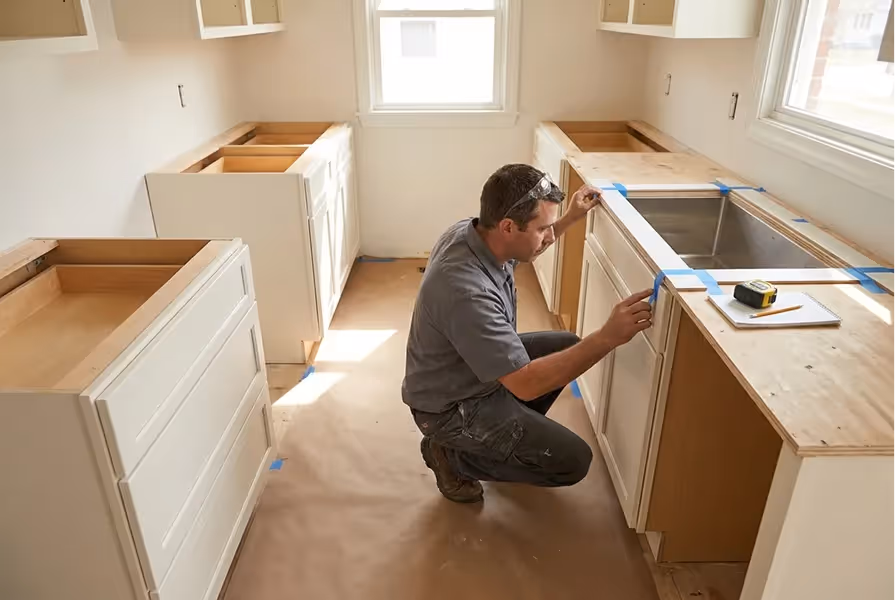

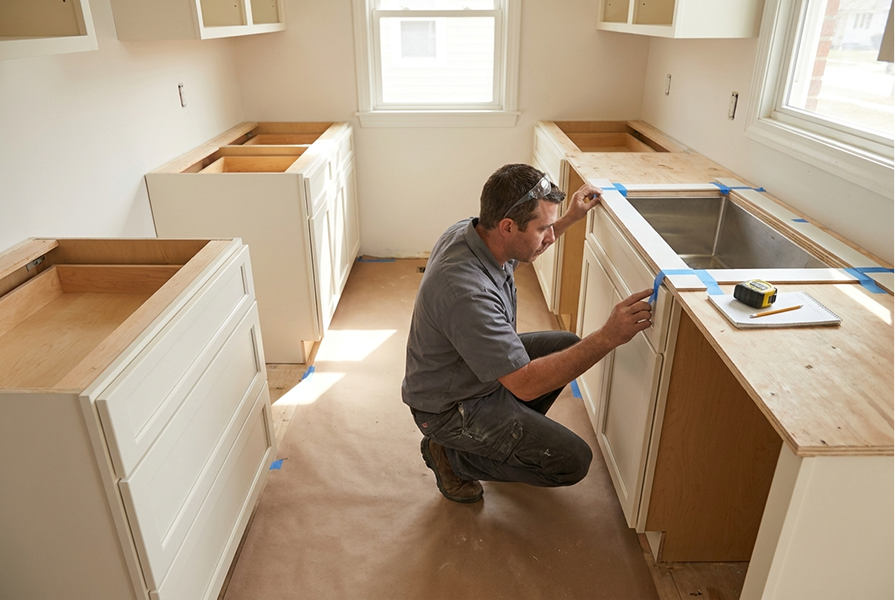

Countertop fabricator templating a newly installed kitchen cabinet run in Tacoma

Flooring, Backsplash, and Fixtures: 1 Week

With cabinets and countertops in place, the finishing work moves fast:

  • Flooring installation (1-2 days for most kitchens)
  • Backsplash tile (1-2 days)
  • Plumbing fixtures (sink, faucet, disposal)
  • Electrical fixtures (lighting, outlets, switches)
  • Appliance installation and hookup

Final Inspections and Punch List: 3-5 Days

Pierce County does a final inspection to sign off on all permitted work. Your contractor walks the project with you to create a punch list of any touch-ups, adjustments, or minor fixes. A good contractor handles punch list items within a few days.

What Affects Your Timeline (Tacoma-Specific Factors)

National averages are one thing. These are the factors that actually impact your kitchen remodel timeline in Tacoma and Pierce County:

Pierce County Permits

If your remodel involves electrical, plumbing, structural, or mechanical changes, you need permits from Pierce County Planning and Public Works. Cosmetic-only work (paint, hardware, backsplash) does not require permits.

Current permit processing times for residential projects run 2-4 weeks. Your contractor should file the application and manage the process. If you're working with a contractor who tells you to skip permits, that's a red flag.

For a detailed breakdown of what does and doesn't require a permit, check out our guide: Do I Need a Permit to Remodel My Kitchen in Tacoma?

Seasonal Factors in the Pacific Northwest

Timing matters in Western Washington:

Spring (March-May): The sweet spot. Contractor schedules start opening up after winter, weather improves for deliveries and any exterior work, and you'll have your new kitchen ready for summer entertaining. This is the most popular time to start, so book your contractor early.

Summer (June-August): Great weather, but contractors are at peak demand. Expect longer wait times to get on the schedule. If you want a summer start, begin your planning in March or April.

Fall (September-November): Solid option. Contractor demand dips slightly, and you can sometimes negotiate better pricing. Rain picks up but rarely affects interior kitchen work directly (though it can slow material deliveries).

Winter (December-February): Lowest demand, which can mean better availability and pricing. The downsides: holiday schedules can cause gaps, shorter daylight hours for exterior work, and PNW rain can slow deliveries. Interior kitchen work itself isn't weather-dependent, but everything around it moves a bit slower.

Material Lead Times in 2026

Current lead times for common kitchen materials:

  • Stock cabinets: 1-2 weeks
  • Semi-custom cabinets: 3-6 weeks
  • Fully custom cabinets: 6-10 weeks
  • Quartz/granite countertops: 2-4 weeks after template
  • Tile (backsplash, flooring): Usually in stock; specialty tiles 2-3 weeks
  • Appliances: Most major brands in stock; high-end or specialty 4-8 weeks

The biggest timeline killer? Changing your mind on cabinets after they've been ordered. If you're going custom, be 100% certain before the order goes in.

Homeowner Decision Speed

This is the factor nobody talks about, but contractors know it well. Every time a homeowner takes two weeks to pick a backsplash tile or changes their mind about cabinet hardware, the project slips. Decisions that seem small can cascade into real delays.

The fix: Make all your design selections before demolition day. Have your cabinet style, countertop material, backsplash tile, flooring, fixtures, paint colors, and appliances picked out and ordered. If you're not sure about something, settle it during the design phase, not during construction.

Unexpected Surprises (Especially in Older Tacoma Homes)

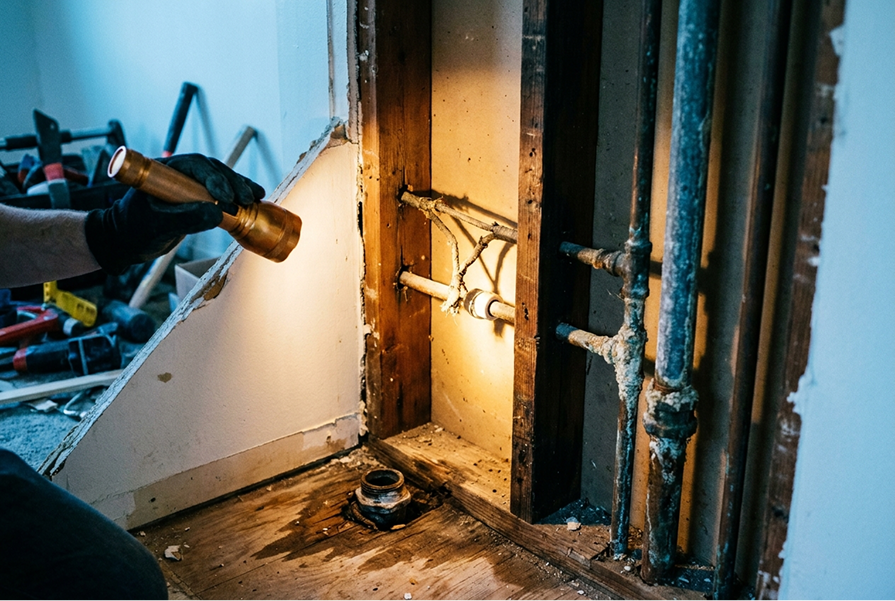

Outdated knob-and-tube wiring discovered inside kitchen walls during a Tacoma remodel

Tacoma has a lot of homes built before 1960. When you open up walls in older homes, you often find:

  • Outdated or unsafe wiring (knob-and-tube, aluminum)
  • Galvanized or lead plumbing that needs replacement
  • Water damage or rot in subfloors and wall framing
  • Asbestos in old flooring or insulation
  • Framing that doesn't meet current code

These discoveries add time and cost. A good contractor builds contingency into the schedule, but you should mentally prepare for 1-2 weeks of additional work if your home is older. Budget an extra 10-15% for the unexpected.

How to Keep Your Remodel on Schedule

You can't control everything, but you can control the biggest sources of delay:

Before construction starts:

  • Finalize ALL design selections (cabinets, countertops, tile, flooring, fixtures, appliances, paint)
  • Order long-lead materials as early as possible (custom cabinets especially)
  • Set a realistic budget with 10-15% contingency for surprises
  • Choose a contractor who manages the full timeline, not just individual trades

During construction:

  • Be available for decisions. When your contractor calls with a question, answer it the same day
  • Don't make changes mid-project unless absolutely necessary. Change orders are the number one cause of delays
  • Set up a temporary kitchen (microwave, mini-fridge, paper plates) so you're not pressuring the crew to rush
  • Trust the process. There will be days when it looks like nothing happened. Drying times, inspection waits, and scheduling gaps are normal

Communication:

  • Ask your contractor for a written schedule with milestones
  • Get weekly progress updates
  • Know when inspections are scheduled and what's needed to pass them

Frequently Asked Questions

Can I live in my house during a kitchen remodel?

Yes, and most homeowners do. Set up a temporary kitchen in another room with a microwave, mini-fridge, and some counter space. It's not glamorous, but it works. The only time it gets uncomfortable is during a full gut when the water is shut off for plumbing work (usually a day or two).

How long does a small kitchen remodel take?

A cosmetic refresh on a small kitchen (under 100 sq ft) can be done in 2-3 weeks. If you're replacing cabinets and countertops but keeping the layout, plan for 5-7 weeks of construction plus lead time on materials.

Do I need a permit for a kitchen remodel in Tacoma?

It depends on the scope. Cosmetic changes (paint, hardware, backsplash) don't require permits. Anything involving electrical, plumbing, structural, or mechanical changes does. We wrote a full guide on this: Do I Need a Permit to Remodel My Kitchen in Tacoma?

What is the most time-consuming part of a kitchen remodel?

Material lead times, especially for custom cabinets (6-10 weeks) and countertop fabrication (2-4 weeks after templating). The construction itself moves steadily once materials arrive and permits are in hand. The waiting is what tests your patience.

How far in advance should I plan my kitchen remodel?

Start planning 2-3 months before you want construction to begin. That gives you time to finalize design, order materials (especially custom cabinets), secure permits, and get on your contractor's schedule. If you're targeting a spring start, begin planning in January or February.

What's the best time of year to remodel a kitchen in Tacoma?

Spring is the sweet spot. Contractor availability is solid, weather cooperates for deliveries, and you'll have your new kitchen ready for summer. Fall is a good second choice, with slightly lower demand and potential pricing flexibility.

Ready to Get a Realistic Timeline for Your Kitchen?

Every kitchen remodel is different. The timelines above give you a solid baseline, but your specific project depends on your scope, your home, and your design choices.

CHC specializes in kitchen remodels for Tacoma and Pierce County homeowners. We'll walk through your project, give you an honest timeline, and keep it on track from start to finish.

Get a free consultation and realistic timeline for your kitchen remodel

Creative Renovations WA serves homeowners throughout Pierce County and South King County, specializing in kitchen remodeling, bathroom remodeling, and whole-home renovations. Based in Tacoma, WA.
